Scrum Points and Velocity

Mark Kampe

Introduction

We can break up a large project into many milestones. But all project milestones do not represent equal amounts of work, which makes it hard to translate milestone achievements into quantitative measures of our progress. How can we translate milestones into linear measures of our progress towards completion?

Earned Value Analysis attempts to associate dollar values (a fraction of the entire project value) with milestones, and so enable the achievement of milestones to be directly translated into quantified progress. The Earned Value can be tracked over time to ascertain how well we are doing vs. plan. But Earned Value Analysis allows value to be earned for plans, approvals, and intermediate deliverables. Agile eschews such awards, as they make it possible for a project to claim to have made significant progress without ever actually delivering any working software ... or for a project to appear to be on schedule despite the fact that it is not actually building any working software at all.

The agile revolution is a response to a wide range non-constructive processes that have arrisen in large software projects. One key declaration in the agile manifesto states that "working software is more important than comprehensive documentation." In large projects and large organizations, people are often goaled, not on the creation of software, but on the creation of "process" documents (e.g. schedules, plans, and design notes). Process is good when it enables us to do a better job, but process compliance should never be allowed to become an end in itself. If we goal people on process deliverables, rather working software we create incentives for them to satisfy those goals in ways other than creating working software.

To address this problem, agile methods declare the only valid measure of progress to be delivered functionality,

Scrum Points

Agile methods have a notion of story points, which are a measure of the enhanced product value (to customers) that will be created by enabling a particular story. Product owners use these scores to decide which features should be implemented, and an in which order. Story points are a measure of benefit. But benefit is not a linear function of cost, and we would still like to have a means of tracking our progress vs plan. We need a measure of work performed. Dollars are the most obvious unit for cost, but the estimation will be done by programmers, who find it difficult to think of work in dollars. The most natural way for a programmer to think of work is in hours or days. But there are few reasons why such estimates might prove to be incorrect:

  1. The programmers do not understand the functionality to be implemented.
    The Scrum backlog grooming process is supposed to ensure that all stories at the top of the backlog are clear. An unclear story is not ready to be considered for the next sprint.
  2. The programmers do not understand how the work is to be done.
    One of the most important activities in the Scrum sprint planning process is a discussion (among the entire team) of exactly how each new story will be implemented.
  3. The task is too large and complex to be accurately estimated.
    The Scrum backlog grooming process is supposed to break each story down into pieces that are small enough to be done by a few people in a few days. A task that is too large to be estimated is not ready to be considered for the next sprint.
  4. The programmers could not accurately predict the difficulty of that work.
    There will always be such inaccuracies, but over time:
    1. over- and under-estimates should average out.
    2. we can learn to calibrate estimates vs. actual time.
  5. The programmers could not predict what other interruptions would distract them from that work.
    This is a very significant unknown, but we do not ask programmers to estimate when a task will be done. We only ask them to estimate how many hours/days of uninterrupted work it will take.
In the Scrum sprint planning process, the team discusses each feature and how it will be implemented. After there is agreement on how the job will be done, each member of the team estimates the required work:

A typical "Planning Poker" deck

The chosen number becomes the Scrum point value of this task. These points will only be earned when the product owner accepts the implementation (and test cases) as satisfying the requirements of the story. Note, however, that even though the assigned points were based on an estimated number of hours (or days), we will never discuss a task in terms of hours (or days). Describing something as a four-hour task creates the expectation that it will be done four hours hence ... and such assumptions are seldom correct. To prevent such misunderstanding, we only talk about tasks in terms of points.

Scrum Velocity

At the end of each sprint, we can add up the number of points that the team earned (the values of the stories accepted as completed by the product owner). This yields a velocity (in points per sprint). This velocity is not expected to agree with the original basis for the estimates. It has been corrected for: Over time, if the same team is doing the same type of work, their velocity will average out to approach a constant value. We will call this long term average value the team's sprint velocity. This velocity can be used to:

Note that points are only earned for implemented user stories, accepted by the product owner. There are no points awarded for:

This might seem unfair, as these are all very important activities. Scrum agrees that these are vital activities ... but they do not directly deliver new user stories. These are all viewed as overhead activities: parts of the cost of implementing the software that earns points. Is there a danger that a team would cut back on these activities to obtain short-term velocity improvements? Perhaps, but over the medium-to-long term these activities should result in better velocity. New tools, and techniques should improve our productivity. Improved designs and implementation should reduce the amount of time we spend working on bugs. Don't follow best practices because they are best practices. Follow them because they make a difference.

Progress Tracking

Large project people might complain that only awarding points upon acceptance of functionality by the product owner does not enable the fine-grained tracking required for early problem detection. Note, however, that Scrum requires that functionality be delivered in stories that are simple enough to be implemented by a few people in a few days. A typical team will complete 5-10 stories per week ... which should enable very fine grained progress tracking.

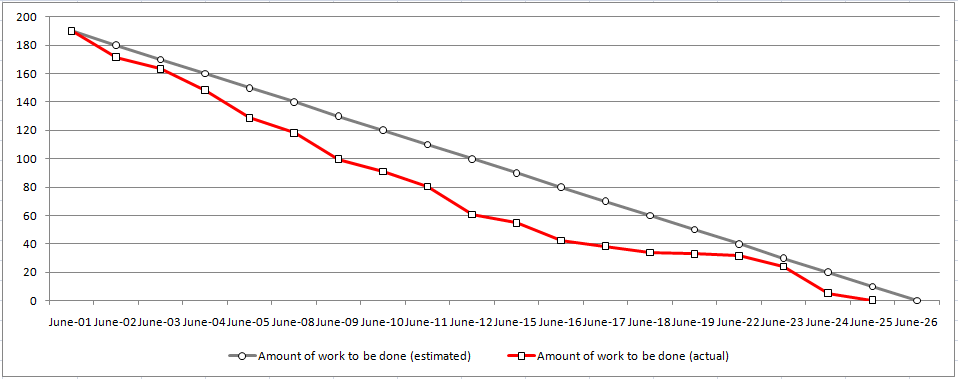

The Scrum equivalent of an earned value graph is called a burn down chart. It plots the number of points earned to-date against vs. date (days into sprint). A constant velocity burn-down rate is generally plotted on the same axes to enable the assessment of progress vs expectations.

As we progress towards the completion of all of the stories we want to include in a particular release, the backlog gets drained, the remaining tasks in the backlog become more clearly defined, and the estimates more credible. If we can associate ranges (likely maximum and minimum points), rather than T-shirt sizes, with tasks, we can, at any time, use the team's sprint velocity to project an envelope for the expected completion date of the remaining tasks in the backlog. Such projections have several advantages over "big plan up front" estimates:
